How Can OEM Buyers Avoid Common Mistakes When Sourcing Micro Pumps from China?

Your low-cost pump sample from China looked perfect, but now mass production orders are failing quality checks. This common sourcing mistake stalls projects and inflates budgets, creating massive risk.

The real problem is rarely "sourcing from China" itself, but a flawed evaluation process. Buyers often focus too much on unit price, confusing a good sample with a reliable supply chain, leading to predictable failures in consistency, performance, and compliance.

An image showing a perfect single pump sample on one side and a pile of inconsistent, problematic pumps on the other side
The Risk of Judging a Supplier by a Single Sample

I’ve seen this story play out many times. A buyer feels confident after receiving a perfect, low-cost sample, only to face a crisis six months later with inconsistent batches or unexpected certification issues. The problem isn't the location; it's the sourcing method. Successful sourcing isn't about finding the lowest piece price. It’s about verifying a supplier's engineering depth, process control, and ability to deliver long-term consistency. This article walks through a better evaluation process to avoid these costly traps.

What Do OEM Buyers Usually Get Wrong When Sourcing Micro Pumps from China?

Chasing the lowest quotation seems like a smart business move. But this approach often backfires, leading to technical problems and project delays that wipe out any initial savings.

The most common mistake is overvaluing superficial metrics like unit price and sample quality. Buyers fail to assess a supplier’s batch consistency, engineering support, and process control, which are the true indicators of a reliable OEM partner.

A simple infographic contrasting a price tag with a checklist showing quality, engineering, and consistency
Price vs. Total Value in OEM Sourcing

Why Is Unit Price Often Given Too Much Weight?

Many buyers compare quotations based only on piece price. This comparison table shows why that's a dangerously incomplete picture.

Apparent Savings (The Focus) Hidden Costs (The Reality)
Low Unit Price1 Engineering Rework & Delays
Low Tooling Cost Unstable Batch Performance
Inexpensive Samples High After-Sales & Warranty Costs

Why Are Samples Not Enough to Judge a Supplier?

A good sample is a good start, but it's not proof of capability. A single perfect unit tells you nothing about a supplier's ability to maintain long-term quality. Specifically, a sample does not prove:

Sample success is not the same as mass production readiness.

Why Do Buyers Confuse “Can Make It” with “Can Supply It Reliably”?

Many suppliers can assemble or copy a pump. But true OEM supply is about much more than that. It demands absolute repeatability, documented quality control, fast technical collaboration, and a stable supply chain. The ability to make one good pump is fundamentally different from the ability to reliably supply 5,000 identical ones.

Why Is Technical Evaluation More Important Than Price Comparison?

Your supplier gave you the best price, but the pump fails inside your device. Now you're facing a redesign, and the project timeline is in jeopardy.

This happens when the technical requirements are not clearly defined upfront. A meaningful quotation is impossible without a deep, system-level technical discussion before any prices are exchanged.

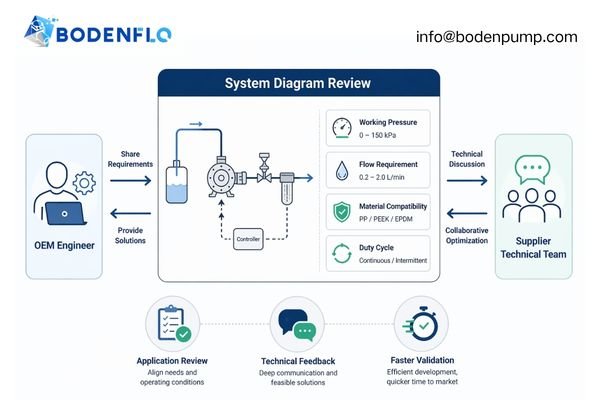

An image of an engineer on a video call with a supplier, pointing to a system diagram
Technical Collaboration with Pump Supplier

What Technical Questions3 Should Buyers Ask Before Quoting?

Before you even ask for a price, start a technical dialogue. This table outlines the key questions to ask.

Technical Area Key Questions to Ask
Performance What is the required flow at the actual working pressure/vacuum?
Operation What is the voltage, and what is the expected duty cycle (continuous or intermittent)?
Media What is the exact medium (air, water, specific chemical, temperature)?
System Are there strict limits on noise, vibration, or lifetime? What are the tubing conditions?
Control Is a simple brushed motor okay, or do you need a brushless motor with PWM/FG control?

Why Do Incomplete Requirements Lead to Wrong Quotations?

If a supplier has only partial information, they'll quote a standard model based on its maximum flow rate under ideal, no-load conditions. The price will look competitive, but the pump will be unsuitable for your real-world system, leading to wasted time and money.

What Happens When Buyers Skip System-Level Discussion4?

When you choose a pump without discussing system integration, you invite predictable problems. Skipping this step often leads to:

  • The pump failing due to unexpected back pressure or suction conditions.
  • Unforeseen EMC issues that interfere with other electronics.
  • Poor performance once the pump is installed inside the final product's enclosure.
  • Costly rework and project delays that negate any initial savings.

How Can Buyers Check Whether a Chinese Pump Supplier Really Understands OEM Projects?

You've received several quotations, but how do you know which supplier is a true engineering partner and which is just a reseller? Their response quality tells you everything.

The quality of a supplier's communication reveals their internal capability. Use this comparison table to spot the difference between a strong partner and a weak supplier.

Sign of a Strong Engineering Partner Red Flag of a Weak / Trading Supplier
Asks detailed questions about your application. Sends only a catalog PDF and asks for quantity.
Understands working pressure and media compatibility. Pushes a "best-selling model" without review.
Explains technical trade-offs and limitations. Cannot explain test conditions or material specs.
Offers structured technical suggestions. Avoids discussing long-term reliability.
Replies with clarifying questions and reasoning. Replies with vague confidence and overpromising.

What Quality Risks Should OEM Buyers Watch for Before Placing Orders?

Your sample passed all tests, so you placed a large order. But the production units show high variation, causing failures in your assembly line.

This is the risk of assuming sample quality equals batch consistency. For an OEM, the single most important quality metric is repeatability across thousands of units.

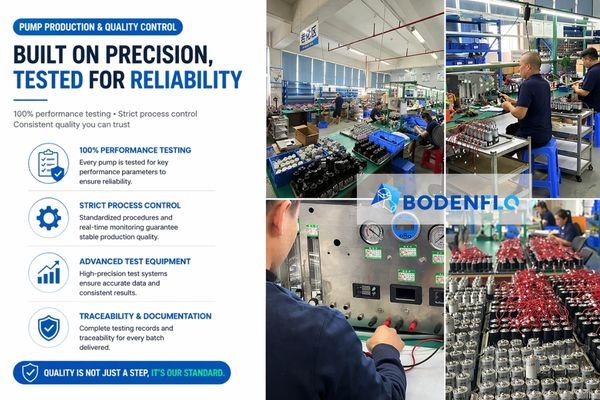

An image showing a production line with pumps being tested at multiple stations with clear QC documentation
Pump Production and Quality Control

Why Is Batch Consistency More Important Than a Single Good Sample?

Anyone can build one perfect sample. The real challenge is manufacturing 5,000 units with the exact same performance. This requires tight control over key variables like:

  • Motor performance consistency.
  • Diaphragm and valve material batches.
  • Assembly tolerances and fixture accuracy.
  • Standardized and calibrated testing equipment.

What Production and QC Questions Should Buyers Ask?

A professional supplier will welcome questions about their quality process. Use this checklist to guide your inquiry:

  • Incoming Materials: Do you have an inspection process for critical components like motors?
  • Final Testing5: Do you perform 100% final testing on every pump, or only sampling?
  • Test Standards: What specific performance items are checked during the final test?
  • Documentation: Are the test conditions (pressure, voltage) clearly documented?
  • Traceability: Can you trace a finished pump back to its production batch?

Why Do Certification and Compliance Become Hidden Sourcing Risks?

The supplier's website showed a CE logo, but now your product is failing EMC testing. The project is halted, waiting for a solution.

Certification is a common hidden risk. Having a certificate for a component is not the same as ensuring your final product is compliant. This requires a supplier who can provide proper documentation.

An image of various certification logos like CE, RoHS, and REACH
Pump Certification and Compliance

What Certifications Do Buyers Commonly Need?

Depending on your market, you will likely need compliance documents for standards like CE, RoHS, and REACH. For complex devices, support for EMC (electromagnetic compatibility) testing6 is also critical.

Why Is “Certificate Available” Not the Same as “Your Product Is Ready”?

A supplier might have a CE certificate for a pump, but that doesn't guarantee your system will pass. EMC performance, for example, can change dramatically once the pump is integrated with your electronics. Furthermore, the certificate may be outdated or for a different model.

What Should Buyers Verify Before Committing?

  • Does the certificate match the exact model you are quoting?
  • Are the material declarations (RoHS/REACH7) current?
  • Can the supplier provide technical files to support your system-level certification?
  • Has the pump been used in similar compliant projects before?

How Do Logistics, Communication, and Lead Time Affect Sourcing Success?

Your pump price is great, but delivery is always late, disrupting your production schedule. This delay costs more than you ever saved on the unit price.

Logistical reliability and clear communication are just as critical as technical quality. A great pump that arrives late or is built to the wrong specification is useless.

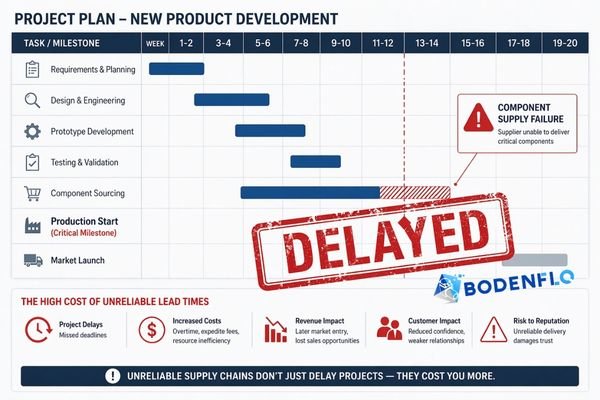

An image showing a project timeline with a red 'DELAYED' stamp on it due to supply chain issues
The High Cost of Unreliable Lead Times

Why Does Lead Time Reliability Matter as Much as Price?

Project delays cost money. Unreliable lead times, often caused by poor planning or unstable raw material supply from the pump manufacturer, can halt your entire production line. The cost of this downtime almost always exceeds any small savings on the pump's unit price. A supplier who delivers consistently on schedule is a valuable partner.

How Can Buyers Reduce Communication Risk?

Most sourcing mistakes happen because of miscommunication. To avoid this, you must have disciplined documentation. Always:

  • Confirm the exact model number and version in all written communication.
  • Get formal approval on specifications and test methods before issuing a PO.
  • Use drawings and photos to clarify details.
  • Specify packaging, connector, and labeling requirements in detail.

How Should OEM Buyers Evaluate the Total Cost of a Chinese Micro Pump Supplier?

You saved 15% on the pump's unit price, but the project was delayed by two months due to rework. Were those initial savings worth it?

The cheapest pump can easily become the most expensive option. True cost evaluation goes far beyond the price on a quotation. It's about evaluating the Total Cost of Ownership.

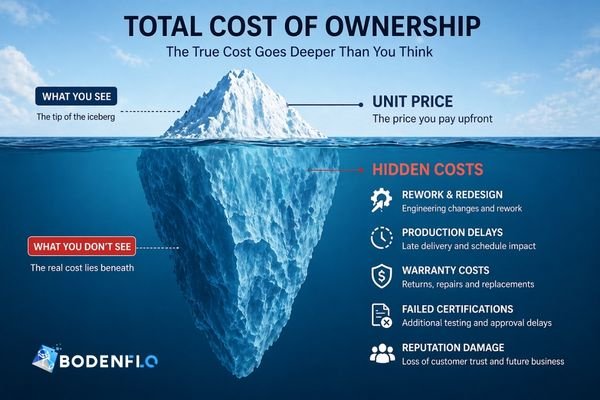

An iceberg diagram showing the small
The Total Cost of Ownership for a Micro Pump

What Is a Better Evaluation Model Than Unit Price?

Instead of ranking suppliers by price, rank them by their ability to reduce your total project risk.

Traditional Model (Price-First) Better Model (Total Risk-First)
1. Price 1. Technical Fit & Engineering Support
2. Lead Time 2. Proven Batch Consistency & QC Process
3. Sample Quality 3. Compliance & Certification Support
4. Long-Term Supply Stability & Communication
5. Price

What Practical Steps Can Buyers Take Before Choosing a Supplier?

Moving from theory to practice is key. Following a structured, step-by-step validation process dramatically increases your chances of finding a great long-term partner.

A disciplined approach prevents you from being swayed by a low price or a nice-looking sample. It forces an objective evaluation of a supplier's true capabilities.

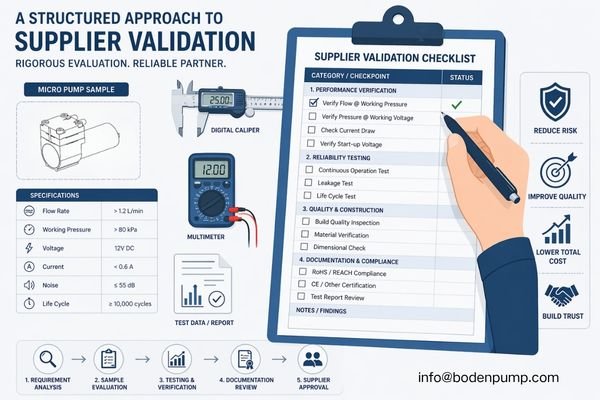

An image showing an engineer going through a checklist while inspecting a micro pump sample
A Structured Approach to Supplier Validation

Here is a simple, five-step process for making a better sourcing decision:

  1. Define Real Working Conditions8: Document your actual flow, pressure/vacuum, voltage, duty cycle, media, and lifespan targets before you talk to anyone.
  2. Compare by Technical Fit: Request technical explanations, not just quotations. Verify their test conditions and assess their engineering depth.
  3. Test Samples Under Real Conditions9: Validate samples using your actual system load, media, and duty cycle. A simple bench test is not enough.
  4. Audit Production and QC Logic10: Ask for a factory video call. A brief tour of their production and testing stations reveals their commitment to quality.
  5. Start with a Controlled Trial Order: Before scaling, place a smaller order to validate consistency, packaging, and communication efficiency in a real-world scenario.

Conclusion

Sourcing micro pumps from China can be highly successful with a disciplined evaluation focused on technical fit and supplier capability. The best supplier isn't the cheapest one; it's the partner that helps you reduce your total project risk.

BODENFLO Support for OEM Micro Pump Sourcing Projects

My team and I understand that successful sourcing is about finding the right engineering fit. We support our OEM clients with detailed application reviews, model selection based on real working conditions, and material or structure customization. We're here to provide sample validation guidance and transparent mass production support to ensure your project succeeds.

If you're starting a new project or facing challenges with your current supplier, contact us at info@bodenpump.com. Let's build a reliable solution together.



  1. Understanding the pitfalls of focusing solely on low unit prices can help buyers make more informed decisions.

  2. Exploring this topic reveals why consistent production is crucial for long-term supplier reliability.

  3. Understanding these questions can help ensure you get the right product for your needs, avoiding costly mistakes.

  4. Exploring this topic can reveal critical insights into integration and performance, saving you time and money.

  5. Exploring the significance of final testing can help you grasp how it ensures every product meets quality standards.

  6. Understanding EMC testing is crucial for ensuring your product meets regulatory standards and functions properly in its intended environment.

  7. Exploring RoHS and REACH compliance helps ensure your products are environmentally friendly and meet legal standards, which is vital for market access.

  8. Understanding real working conditions is crucial for effective sourcing, ensuring products meet your specific operational needs.

  9. Exploring this resource will provide insights on effective testing methods to ensure product reliability.

  10. This link will guide you through essential auditing techniques to ensure quality in manufacturing.
